In November 2025, Spokane voters approved the bond with 61.82 percent support, surpassing the 60 percent threshold required for passage in Washington state.

The $200 million investment is rebuilding Adams and Madison elementary schools, modernizing portions of North Central High School and Garry and Chase middle schools, and establishing a four-year SPS Trades High School on the Spokane Community College campus.

Major Projects

The bond will also fund essential capital improvements across all 66 Spokane Public Schools facilities, including 58 schools. Planned upgrades include roofing, air systems, accessibility improvements, safety and security enhancements, technology upgrades, and improvements to activities and athletics infrastructure for student and community use. Examples of annual school improvement projects can be found on the 2018 bond page.

The projects listed above reflect those funded through the $200 million bond, which voters approved in November 2025. Some projects may be further enhanced through the Together Spokane initiative, a partnership between Spokane Public Schools and the City of Spokane Parks and Recreation.


Cost

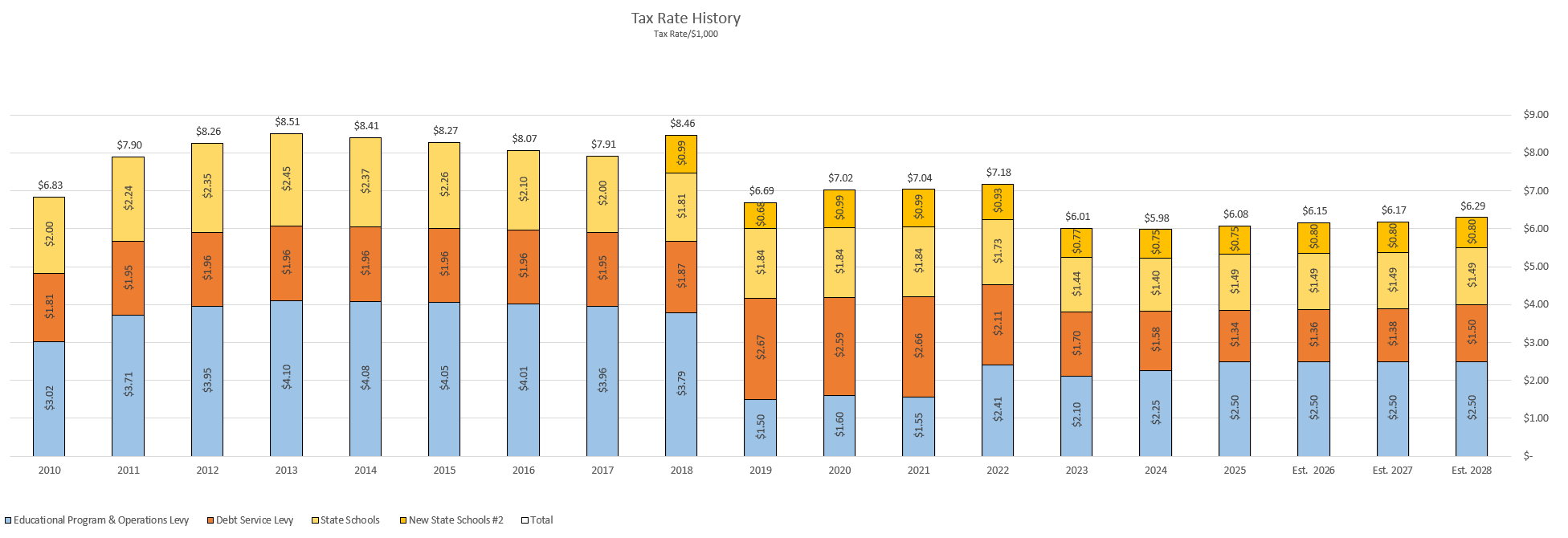

As Spokane Public Schools continues to pay off previous bonds, this bond extension will add approximately two cents to the existing bond bill for an estimated contribution of $1.36 per thousand of assessed value in the first year, which is projected to increase, on average, 2%-3% to account for the rate of annual inflation.

The costs below represent an amount per $1,000 of assessed home value. We've included our Educational Programs and Operational (EP&O) Levy rate, which voters approved in 2024.

EP&O*

Bond#

Total

2025 Actual

$2.50

$1.34

$3.84

2026 Estimated

$2.50

$1.36

$3.86

2027 Estimated

$2.50

$1.38

$3.88

2028 Estimated

$2.50

$1.50

$4.00

2029 Estimated

$2.50

$1.50

$4.00

2030 Estimated

$2.50

$1.50

$4.00

*EP&O approved for collection in 2026, 2027 and 2028. Collection for future years will depend on voter approval.

#Funds principal and interest payments.

Note: These estimated rates are based on information as of Nov. 14, 2024, after the last bond issue was sold. This information will be updated as new information is available, such as assessed value.

Doing More Together

Together Spokane includes a $200 million School bond and a $240 million Parks levy to fund more than 200 projects aimed at strengthening neighborhoods, improving public health, and supporting economic growth. Both measures were approved by voters in the Nov. 4, 2025 election, with the school bond receiving 61.82% approval and the Parks levy passing with 55.8% support.

About the Spokane Public Schools Bond

Active Park Levy Projects

The list below is an overview of active Levy construction and design projects, and their status.

  • New park under construction:
    • Meadowglen Park
      • July 2026 - Summer 2027
  • Restroom renovations:
    • B.A. Clark
      • Complete
    • Camp Sekani
      • August 2026 Start
    • Southeast Sports Complex
      • May - October 2026
  • Playground renovations:
    • Westgate Park
      • Fall 2026
  • Citywide playground damage repair:
    • Citywide according to highest need
      • 20 planned, 10 complete
  • Park repairs:
    • Cliff Park (upper portion)
      • Late 2026 / Early 2027 Start
    • Corbin Art Center (veranda)
      • In Design
    • Japanese Garden (pergola roof)
      • Complete
    • Liberty Park (shelter roof)
      • Complete
    • Aquatic Centers
      • Active / Ongoing
  • Maintenance enhancements
    • All 100+ parks
      • Active / Ongoing
  • Pathway improvements:
    • Franklin Park
      • Complete
  • Disc Golf Course renovation:
    • High Bridge Park
      • In Design
  • Sport Court renovations:
    • Friendship Park
      • Spring 2027 Start
    • Riverfront Park
      • Complete
    • Whittier Park
      • August - October 2026
  • Parking lot repairs:
    • Camp Sekani
      • August 2026 Start
    • Southeast Sports Complex
      • May - October 2026
    • Riverfront Park Post Street Lot
      • July - September 2026
  • New irrigation:
    • Cannon Hill Park
      • August - October 2026
  • Project planning:
    • A.M. Cannon Park
      • In Design
    • Audubon Park
      • Fall 2026
    • Coeur d’Alene Park
      • In Design
    • Harmon Park
      • In Design
    • Lincoln Park
      • In Design
    • Minnehaha Park
      • Pre - Design / Seeking Grant

Schools & Parks Together

With the bond and levy approved, these additional projects will be completed with support from community partners:

Explore the 200+ projects of Together Spokane.

* The bond will add $0.02 per $1,000 of assessed property value in the first year with an average increase between 2%-3% per year through 2030.

** The levy will add $0.27 per $1,000 of assessed property value through 2045.

The tax rate for the parks levy will be based on your 2026 taxable assessed property value.

If the assessed value of your home increases after 2026, it won't affect the amount you pay for the levy over the next 20 years.

Starting in 2027, the levy can go up by a maximum of 3% each year until 2031. After 2031, the yearly increase is capped at 1%.
